Delhi-Dehradun Expressway Cave-In Sparks Row: NHAI Blames Blocked Drainage

A road surface cave-in on the Delhi–Dehradun Economic Corridor at Km 55+480 was spotted on July 1, 2026. Just two and a half months after PM Modi inaugurated the ₹12,000-crore expressway. NHAI blamed locals for blocki...

Gauri SaxenaGauri SaxenaNational Desk3 Jul 2026 · 10:48 AM IST5 min read
Road surface cave-in at Km 55 Delhi Dehradun Expressway after rain July 2026
Source: The Times Of India

A road surface cave-in on the newly opened Delhi-Dehradun Economic Corridor has triggered a political row just weeks after Prime Minister Narendra Modi inaugurated the ₹12,000-crore expressway on April 14, 2026.

The damage, reported at Km 55+480 near Gogwan Jalalpur on July 1, was repaired on priority by NHAI, which blamed rainwater stagnation caused by a non-operational drainage system. The Congress, however, questioned the quality of construction and demanded accountability for the damage on one of India’s flagship highway projects.

What Happened at Delhi–Dehradun Expressway

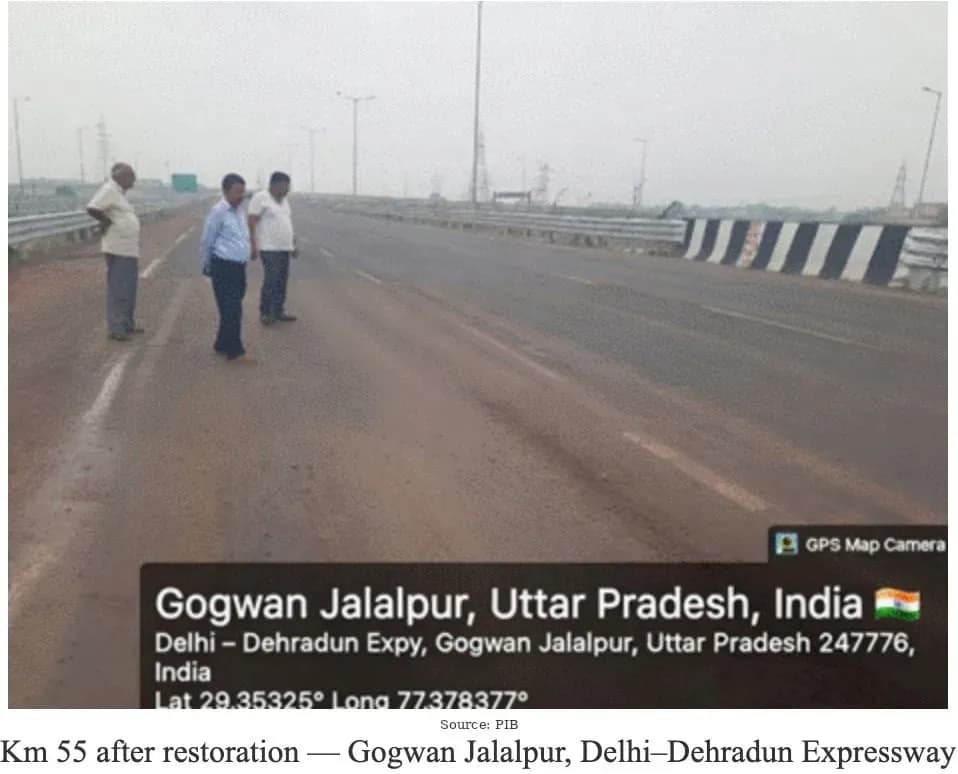

On July 1, 2026, a road surface cave-in was spotted at Km 55+480 on the Delhi–Dehradun Economic Corridor. The spot is identified as Gogwan Jalalpur on the expressway. NHAI's routine patrol team found the damage in the early morning hours. They began repair work right away. The stretch was fixed on priority. Traffic continued to move safely through the area.NHAI released photographs showing the location before and after repairs were completed.

Also Read IIT Ropar's ANNAM.AI Launches HACK CORE 2026 - India's National AI Hackathon for Agriculture

WhatsApp Image 2026-07-03 at 10.27.58

Why the Drainage System Failed: NHAI's Explanation

NHAI issued a formal clarification through a press release July 2. It explained why the drainage system at Km 55+480 was not working.

A balancing culvert was built at the site. It was designed to carry rainwater across the median and away from the road. But it was never switched on. Local residents had been using the culvert opening as a vehicle crossing.

They did not allow NHAI to connect and commission it. So when heavy rain fell, water had nowhere to go. It collected along the carriageway and caused the surface to cave in.

WhatsApp Image 2026-07-03 at 10.27.58 (1)

A second problem made things worse. Permanent slope protection and chute drain works at the same spot are still pending. A land dispute between NHAI and local landowners has blocked this work. Despite repeated attempts, NHAI has not been allowed to begin these works.

In short, two issues outside NHAI's control left the road exposed to rain damage:

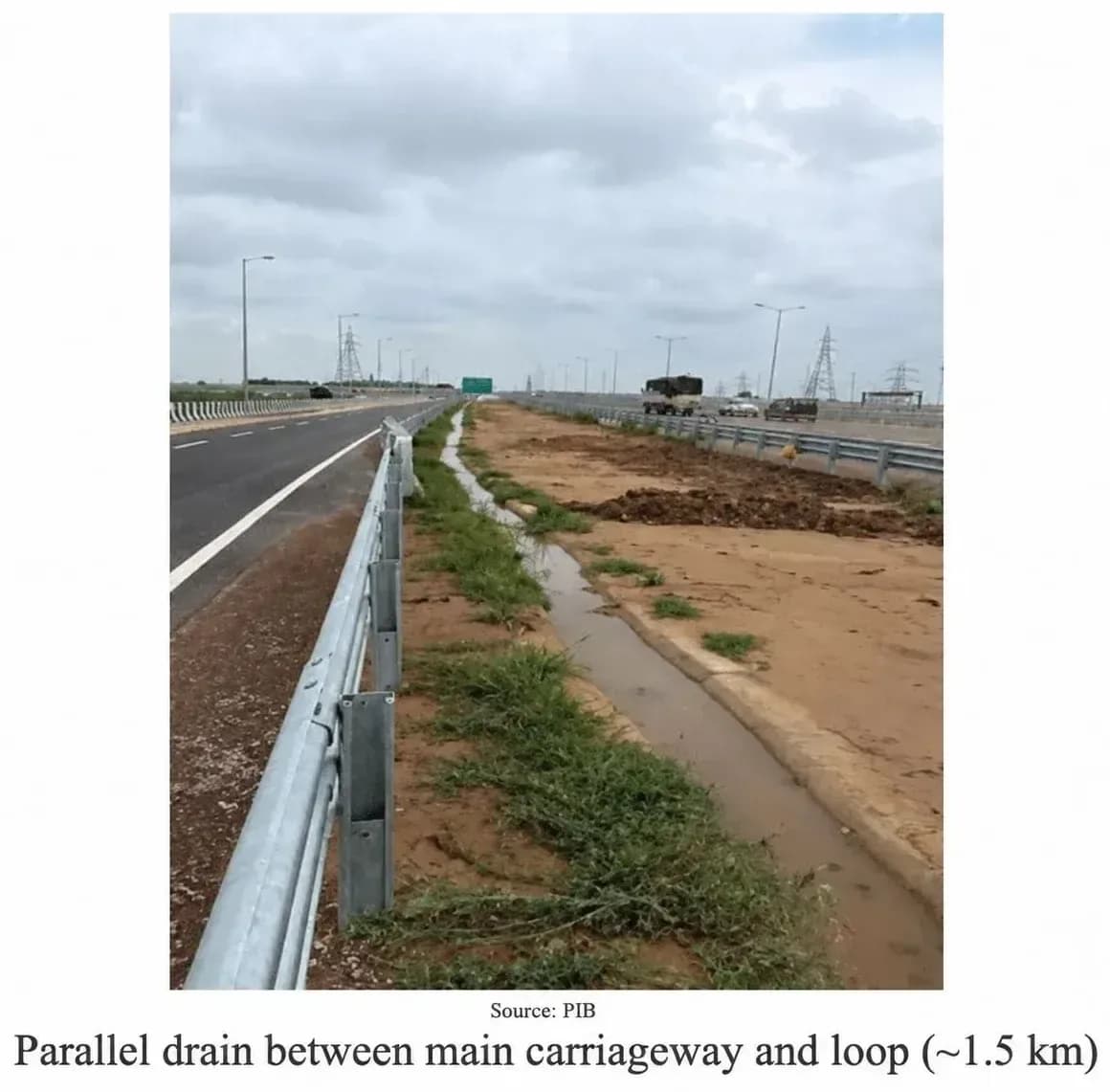

Interim Fix: A 1.5-km Parallel Drain

NHAI has started building a temporary drain as a short-term solution. The parallel drain is about 1.5 kilometres long. It runs between the main carriageway and the loop road.

The drainage gradient has been redesigned. Rainwater will now be directed to the entry/exit point at Km 56+500. This arrangement will stay in place until the balancing culvert is commissioned.

NHAI has released photographs of the new drain route and the designated water disposal point.

Also Read India Is Rewiring Its Logistics Network at an Unprecedented Speed

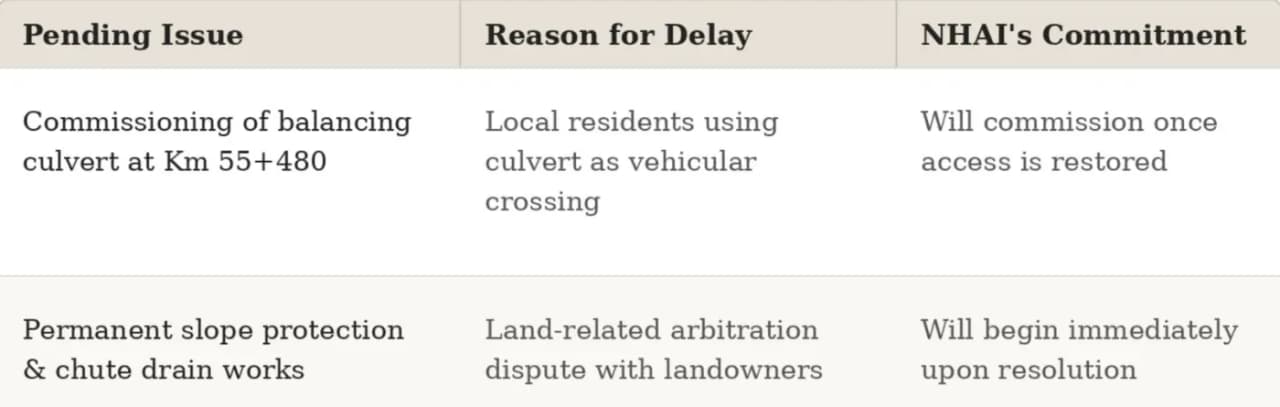

Two Pending Issues That Need Resolution

NHAI has been clear: the long-term solution depends on resolving two ongoing issues.

WhatsApp Image 2026-07-03 at 10.11.07

NHAI says it is monitoring the site continuously. All necessary resources are deployed to keep traffic safe.

Background: A Flagship Expressway Opened Just Months Ago

The Delhi–Dehradun Economic Corridor is one of India's biggest road projects. It was built at a cost of around ₹12,000 crore. PM Modi inaugurated it on April 14, 2026. It opened to the public from April 15.

The expressway cuts travel time between Delhi and Dehradun to about two and a half hours. It also improves connectivity to Haridwar, Rishikesh, and towns in western Uttar Pradesh and Uttarakhand.

The cave-in, coming less than three months after the launch, sparked immediate backlash on social media and in politics.

NHAI took to X to issue its official response, posting:

Congress Hits Out

Congress took to X on July 2 to attack the government. The party said potholes had appeared on the Delhi–Dehradun Expressway within just two months of its launch. It claimed a ₹12,000-crore project deteriorating this fast raises serious questions about build quality.

Congress demanded accountability from NHAI and the Ministry of Road Transport and Highways. It called the cave-in a sign of broader quality-control failures in government infrastructure projects.

NHAI's Commitment Going Forward

NHAI says it is committed to the highest standards of highway safety. It has urged local residents to stop using the drainage culvert as a vehicle crossing. It has also called for a fast resolution of the land dispute so that permanent slope protection work can begin before the monsoon peaks.

Also Read Amit Shah Unveils FCRA 2.0, e-OCI Card in Push for Digital Governance

Regular monitoring, preventive maintenance, and fast response to weather damage remain part of NHAI's operational framework, the authority said.

News4Bharat POV

The cave-in on the Delhi-Dehradun Economic Corridor is not just a road maintenance issue; it is a test of accountability in India’s big-ticket infrastructure push. NHAI says the damage was caused by rainwater stagnation after locals allegedly blocked the commissioning of a balancing culvert, while pending slope protection work remains stuck due to a land dispute. That explanation may address the immediate cause, but it also raises a larger question: how was a flagship expressway opened to traffic while critical drainage and protection works at a vulnerable location were still unresolved?

For commuters, the concern is simple: a ₹12,000-crore expressway expected to cut travel time and boost regional connectivity must also withstand the first major spell of rain after inauguration. For the government and NHAI, the challenge now is not only to repair the damaged stretch but to transparently fix responsibility, resolve local disputes, complete pending drainage work before peak monsoon, and reassure the public that speed of delivery has not come at the cost of long-term safety.
